Phase 3 · 1 Jan 2018 tot 18 Nov 2018 · 25 posts

3 Hull planking

Filter

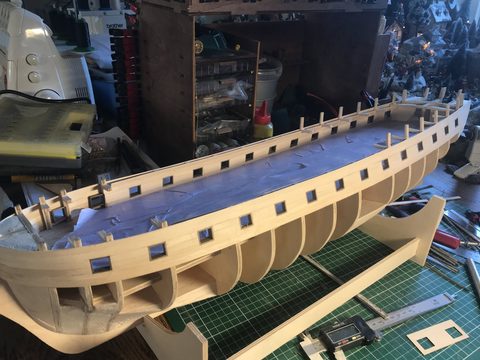

Jump to year or phasePhase 1 Keel and bulkheads2 Planking the gun deck3 Hull planking4 Stern and quarter galleries5 Coppering6 Mouldings, head and rudder7 Fitting out the gun deck8 Guns9 Planking the upper deck10 Rails and capstan11 Ship's wheel and binnacle12 Upper deck guns13 Hammock cranes All posts

January 2018

1 January 2018Hull planking3 photos

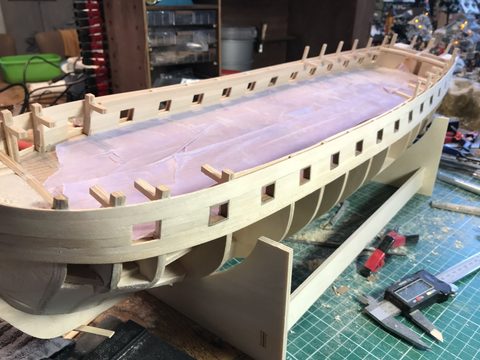

The first ports

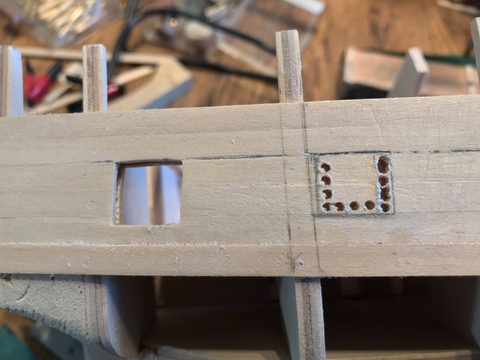

The first gunports are in: drill holes, cut out the centre, then sand, with cutting turning out to be more precise than sanding.

How-to

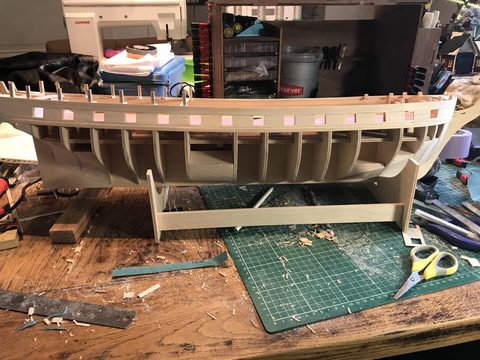

2 January 2018Hull planking9 photos

Starboard done, and a deck that sits too high

All the ports on the starboard side are in, but aft the upper deck sits up to 4 mm too high; a trial fit with a gun shows that the gun does fit once turned round.

Problem and fix Help from Pingu57, pietsan, Johan Verschuren.
3 January 2018Hull planking4 photos

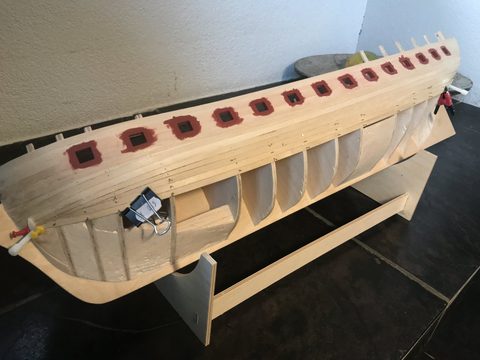

Fourteen ports in a day

All the gunports on both sides are cut to size (14 x 16 mm), after a day from 7 in the morning to 10 at night on the port side.

Milestone Help from paulbo.
4 January 2018Hull planking2 photos

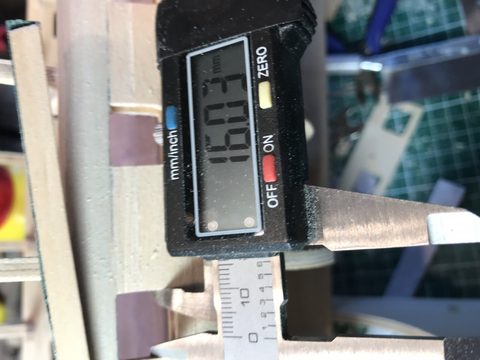

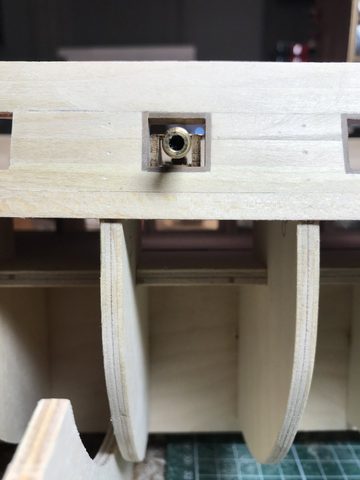

The gun carriage a millimetre and a half lower

By setting the axletrees deeper into the gun carriage the gun drops 1.5 mm, so that the barrel sits more neatly in the port.

Problem and fix Help from pietsan, *Hans*.
5 January 2018Hull planking2 photos

The insides of the ports, and the colour red

The insides of the ports on the port side are in; on Piet's advice the ports with lids go in now as well, and the inner bulwark is going to be red.

Help from pietsan, *Hans*, Danny Mulders, janzwart.
7 January 2018Hull planking4 photos

Linings in and the first coat of red ochre

All the port linings are in and get a first coat of Admiralty red ochre; the colour looks brown, but according to Piet it's right and the paint wants two thin coats.

Milestone Problem and fix Help from pietsan.

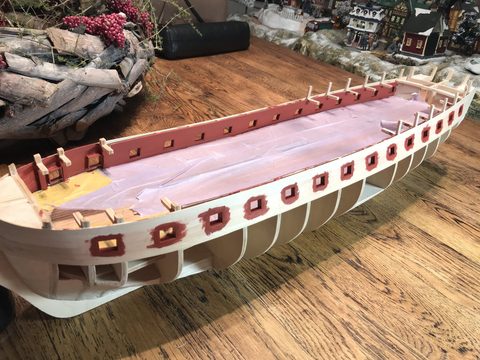

8 January 2018Hull planking2 photos

Painting isn't my thing yet

Two to three coats of red ochre on the linings, with a light rub down in between using very fine 3000 to 5000 grit paper.

How-to Help from paulbo, Hans Groenenberg.

March 2018

11 March 2018Hull planking6 photos

Seven strips a side

After a two-month break, back to the first planking: seven strips on each side, a few of them tapered and one stealer.

24 March 2018Hull planking7 photos

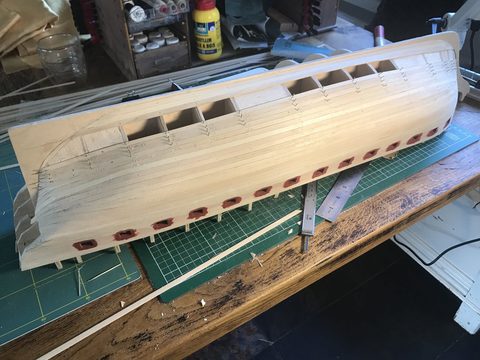

One side closed

The first side of the first planking is closed and the last strip fitted exactly; two strips short in the kit, and a warning from Piet about the hull warping.

Milestone Problem and fix Help from pietsan.

April 2018

1 April 2018Hull planking9 photos

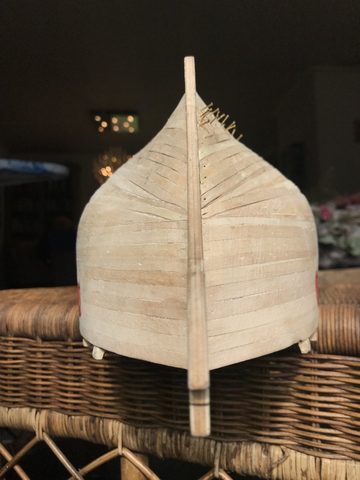

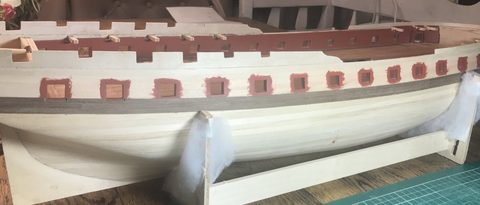

Closed up

The first planking is completely closed and sanded and the keel has stayed straight; for the second layer Piet advises tapering earlier at the bow and using stealers aft.

Milestone Problem and fix Help from pietsan.

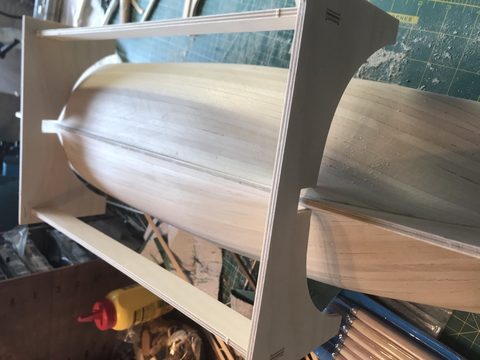

2 April 2018Hull planking8 photos

My own building cradle, and counter planking with the helm port

A building cradle made from bulkhead offcuts lined with felt, the counter planking with the helm port, the bulwark clamped into shape, and the decision to make an open rail like Piet's.

Problem and fix Help from pietsan.

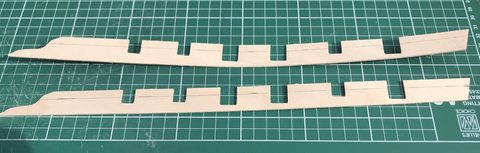

5 April 2018Hull planking8 photos

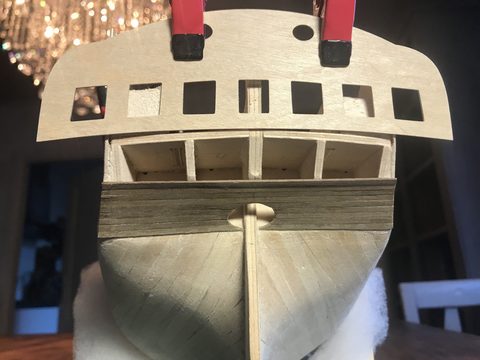

The transom doesn't meet up

The transom doesn't meet the counter planking; the solution is to extend the planking below with a curved piece and drop the transom, without altering the transom plate itself.

Problem and fix Help from *Hans*, pietsan.
15 April 2018Hull planking6 photos

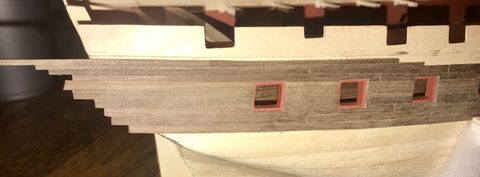

Up past the gunports

At one or two strakes an evening, the first side is closed up past the gunports; on Piet's advice the transition to the bulwark falls exactly halfway across a plank.

Help from pietsan.
16 April 2018Hull planking3 photos

No drop plank, tapering instead

A drop plank belongs only at the bow, not at the stern: the sliver planks come off and the planks are tapered so that they follow the sheer.

Problem and fix Help from pietsan.
21 April 2018Hull planking7 photos

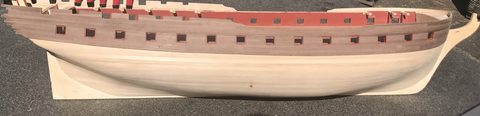

Tiny gaps

Both sides are closed above the wale, but there are tiny gaps between the planks; Henk's trick with sanding dust and diluted PVA solves it, and the cause turns out to be glue residue on the edges of the strips.

Milestone How-to Problem and fix Help from Pingu57, Marc w, Henkl.

May 2018

3 May 2018Hull planking2 photos

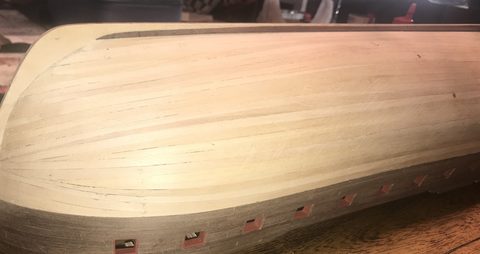

The garboard strake and the false keel

The garboard strake is fitted, tapered on the keel side at the bow; Piet explains that the underside of the keel (the false keel) gets no copper.

Help from pietsan.

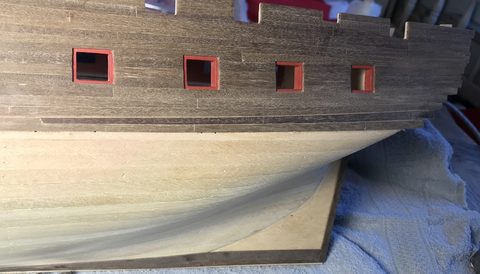

10 May 2018Hull planking2 photos

First stealer and first drop plank

Below the wale, the first stealer at the sternpost and, despite tapering earlier this time, the first drop plank at the bow.

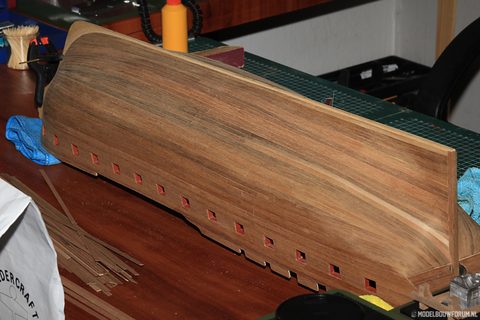

16 May 2018Hull planking2 photos

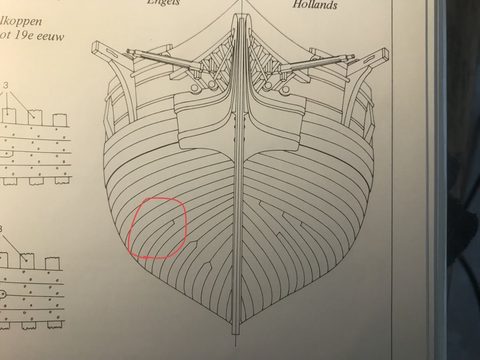

The clinker effect

The strips at the bow keep producing a clinker effect; Piet explains how to determine for each strip where the taper should begin, and why he doesn't combine tapering with drop planks.

Problem and fix Help from Pingu57, pietsan.
17 May 2018Hull planking1 photos

English or Dutch

My drop plank turns out to be made to the Dutch system while the Diana is English; Henk calculates that the 5 mm kit planks are too wide for the curves.

Problem and fix Help from pietsan, Henkl.

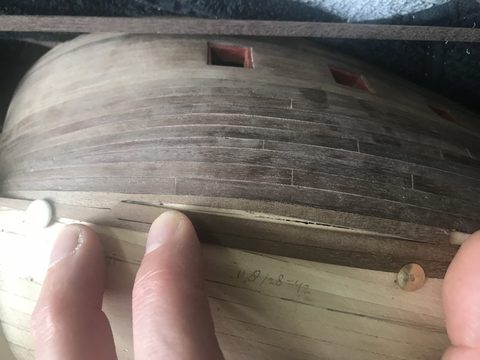

18 May 2018Hull planking4 photos

Found the gap

A drop plank to the true English system reveals where the clinker effect arises; leaving the adjacent plank wider solves it, and the rest of the hull is divided into three belts with battens.

How-to Problem and fix Help from Pingu57, pietsan, Henkl.

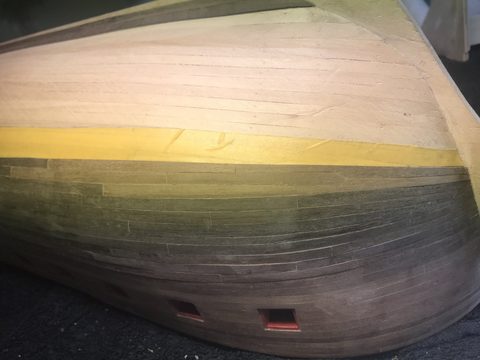

19 May 2018Hull planking11 photos

A drop plank in eight steps

Step-by-step guide to a drop plank using masking tape as a template, plus progress at the sternpost where all the planks are being tapered.

How-to
24 May 2018Hull planking2 photos

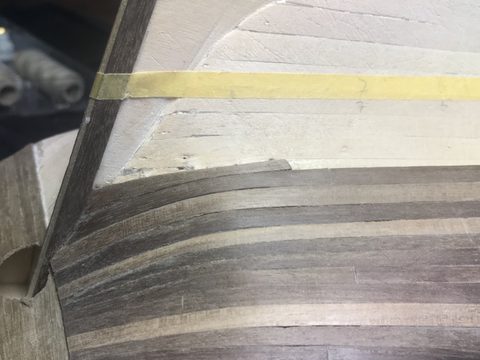

A stealer at the sternpost

A stealer is needed at the sternpost after all; dry fit the real strip first to measure, then glue the stealer and only then the strip.

How-to

September 2018

8 September 2018Hull planking7 photos

Port closed, starboard started

After the summer break the port side is closed below the wale, with four stealers at the sternpost; for the starboard side the hull is divided into four equal belts with seven planks per belt.

Milestone How-to

November 2018

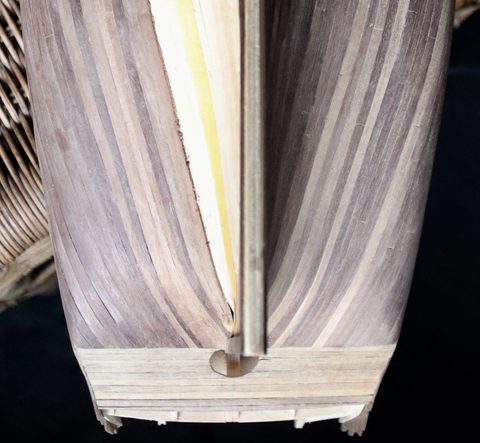

18 November 2018Hull planking7 photos

Completely closed

After two months of silence the second planking is completely closed, with exactly two planks' width left over in the middle; sanding of the sternpost has begun.

Milestone
